Laying the groundwork
Construction of the JEA H2.0® Purification Center began in 2023. Anticipated to be completed by spring 2026, this state-of-the-art center will be located at 7599 Southside Blvd. in Jacksonville. More than just a typical facility, the H2.0® Purification Center demonstrates our commitment to sustainability and environmental stewardship. Follow us on this exciting journey as we pave the way toward a water-smart future for Northeast Florida.
Latest Updates
December 2025

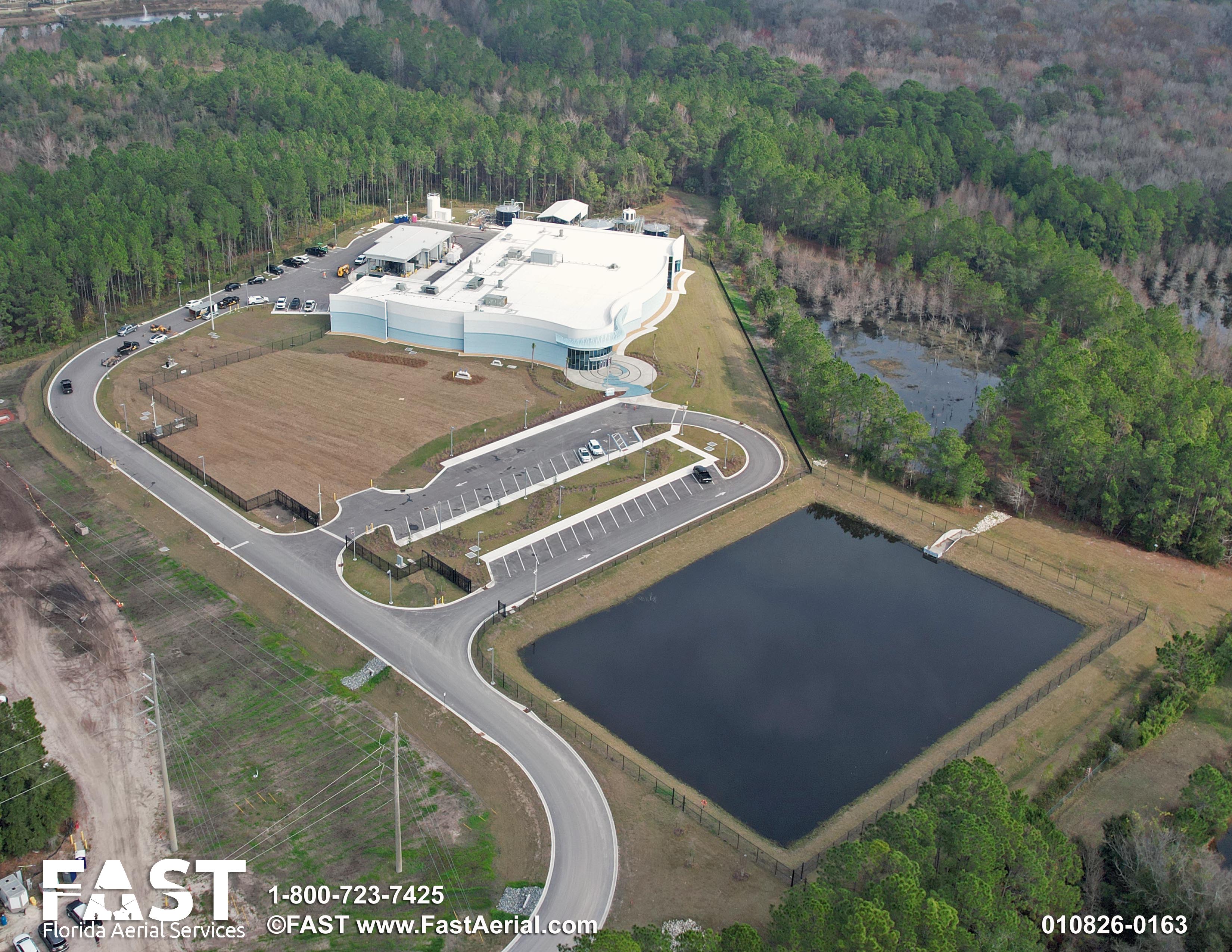

Landscaping Complete, System Testing.
November 2025

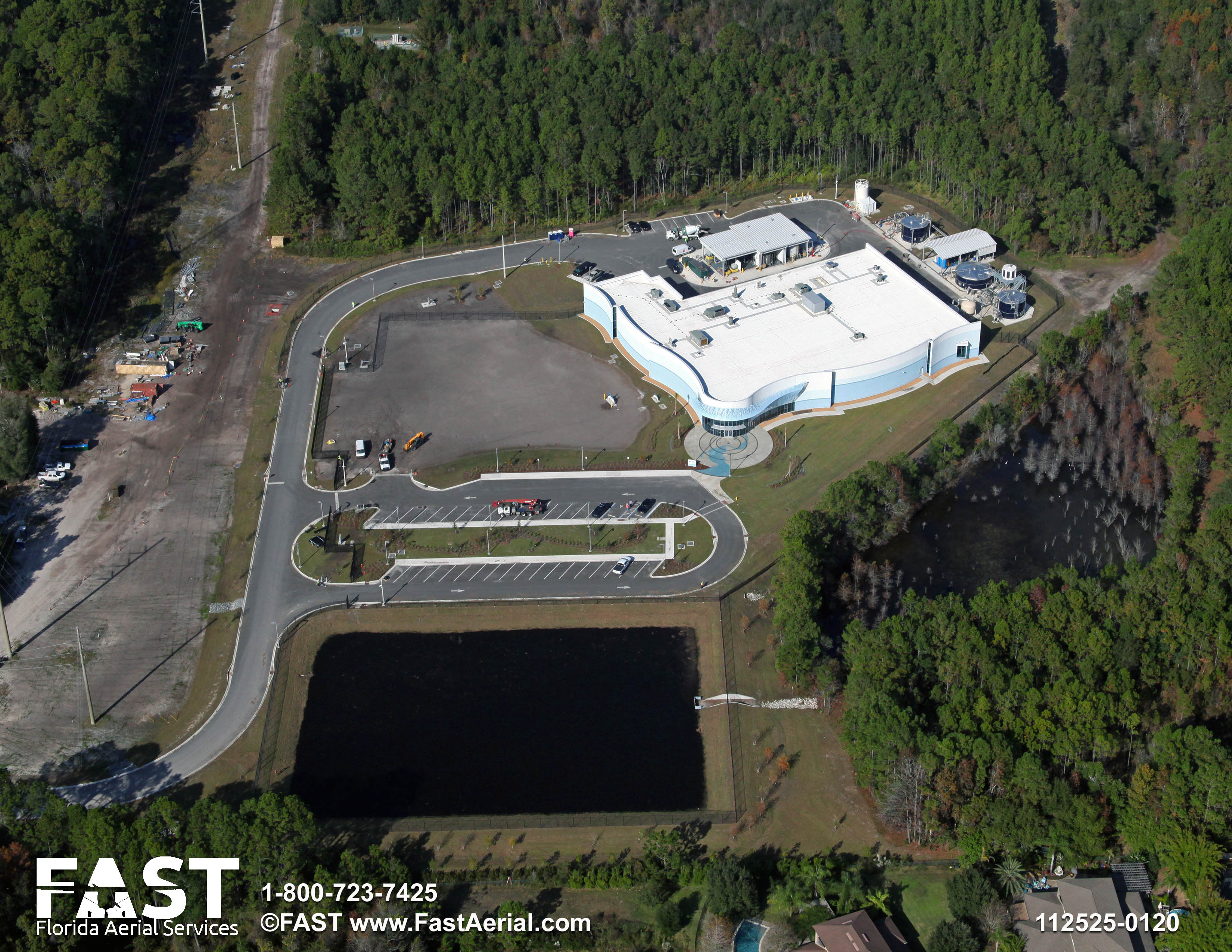

System recirculation, fencing installed.
October 2025

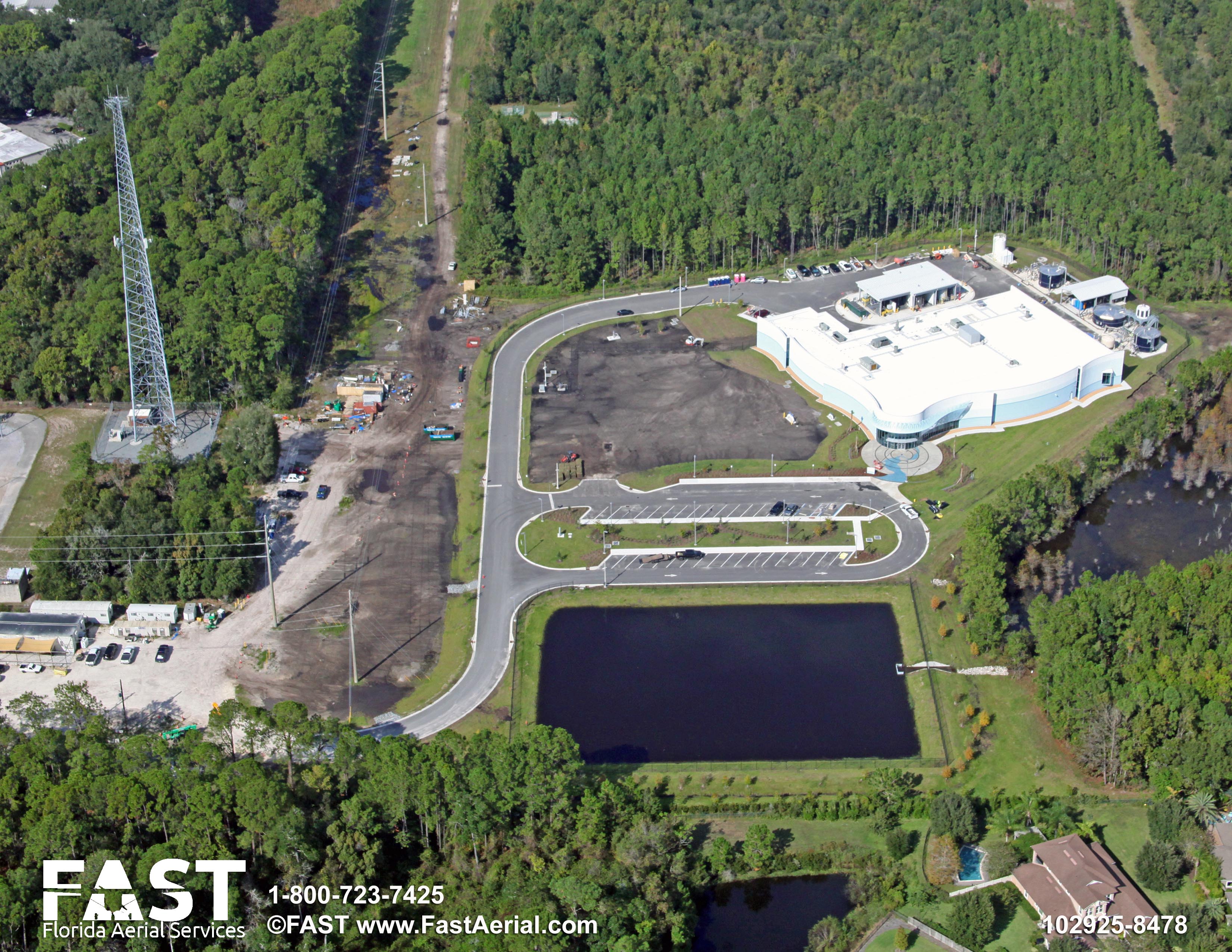

Exhibit training & Process Functional Testing.
September 2025

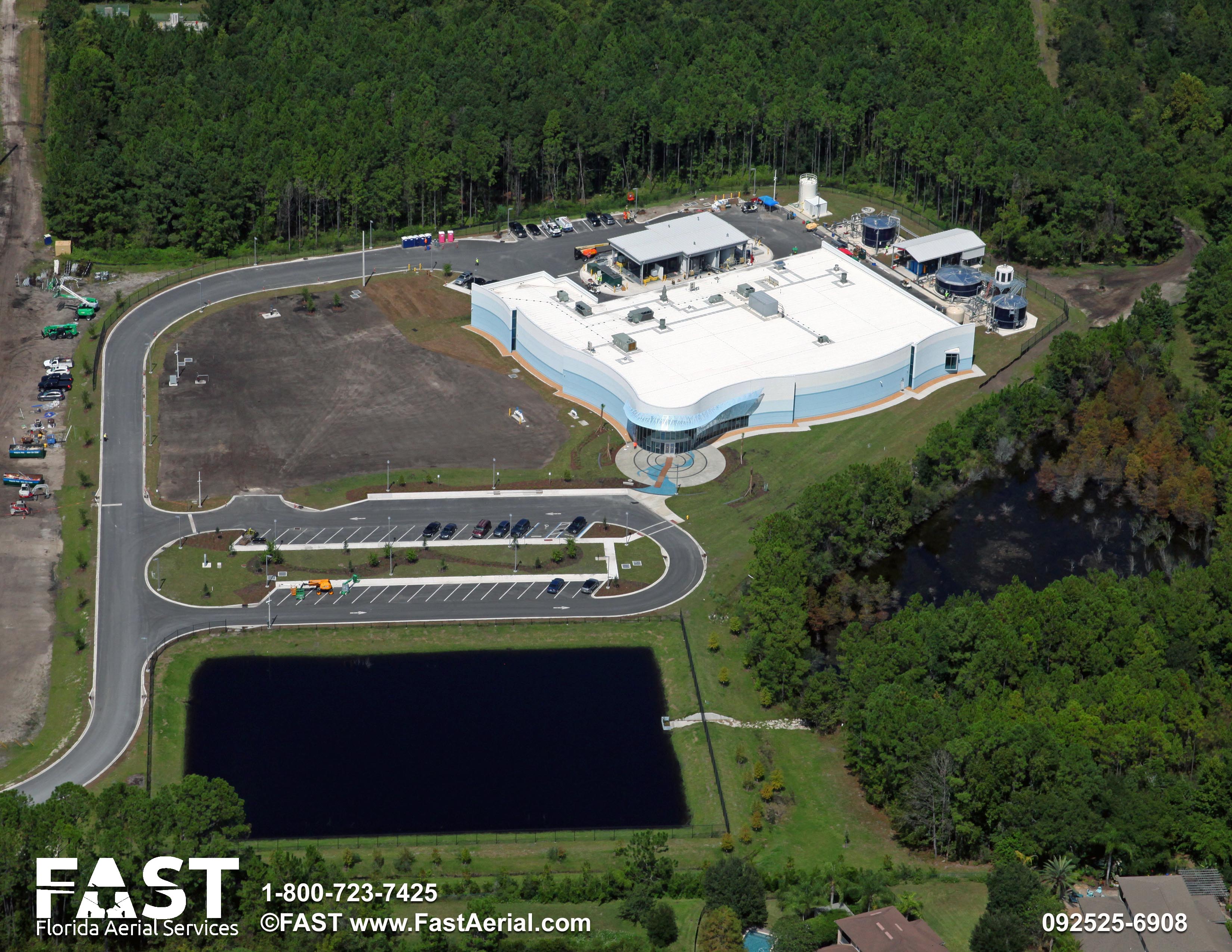

Landscaping installed and visitor center exhibits completed.
August 2025

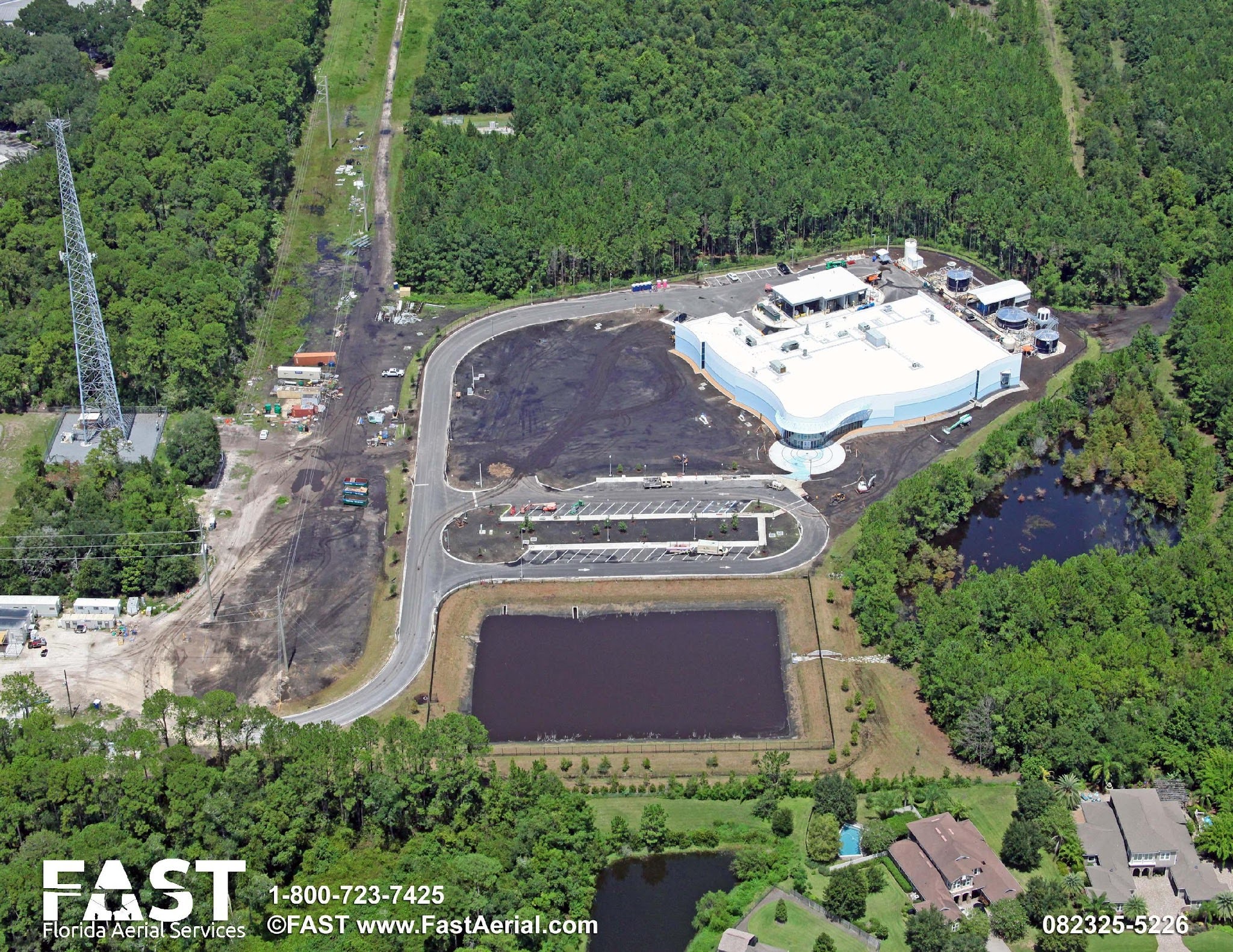

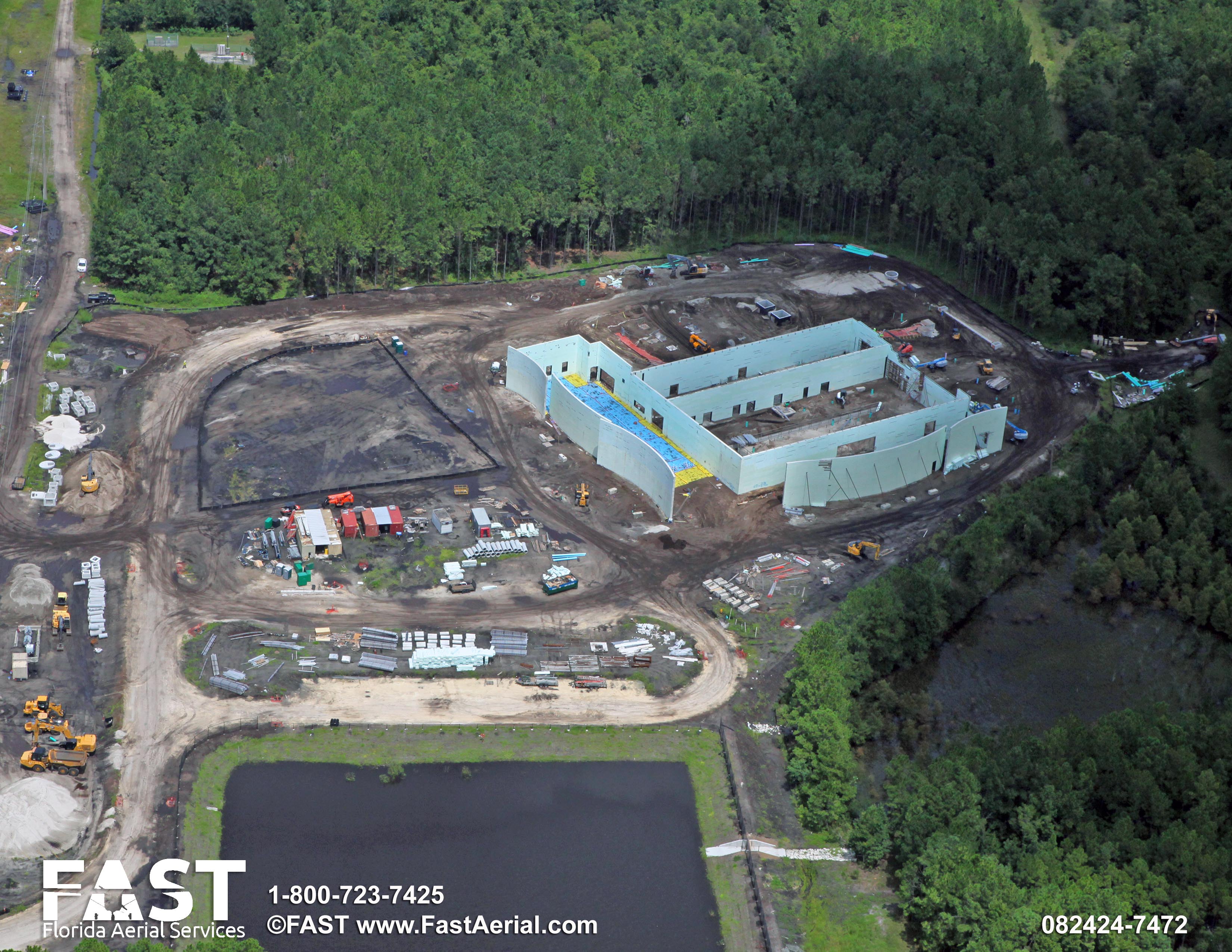

Plaza Poured, Degas Installed, Driller Demob.
July 2025

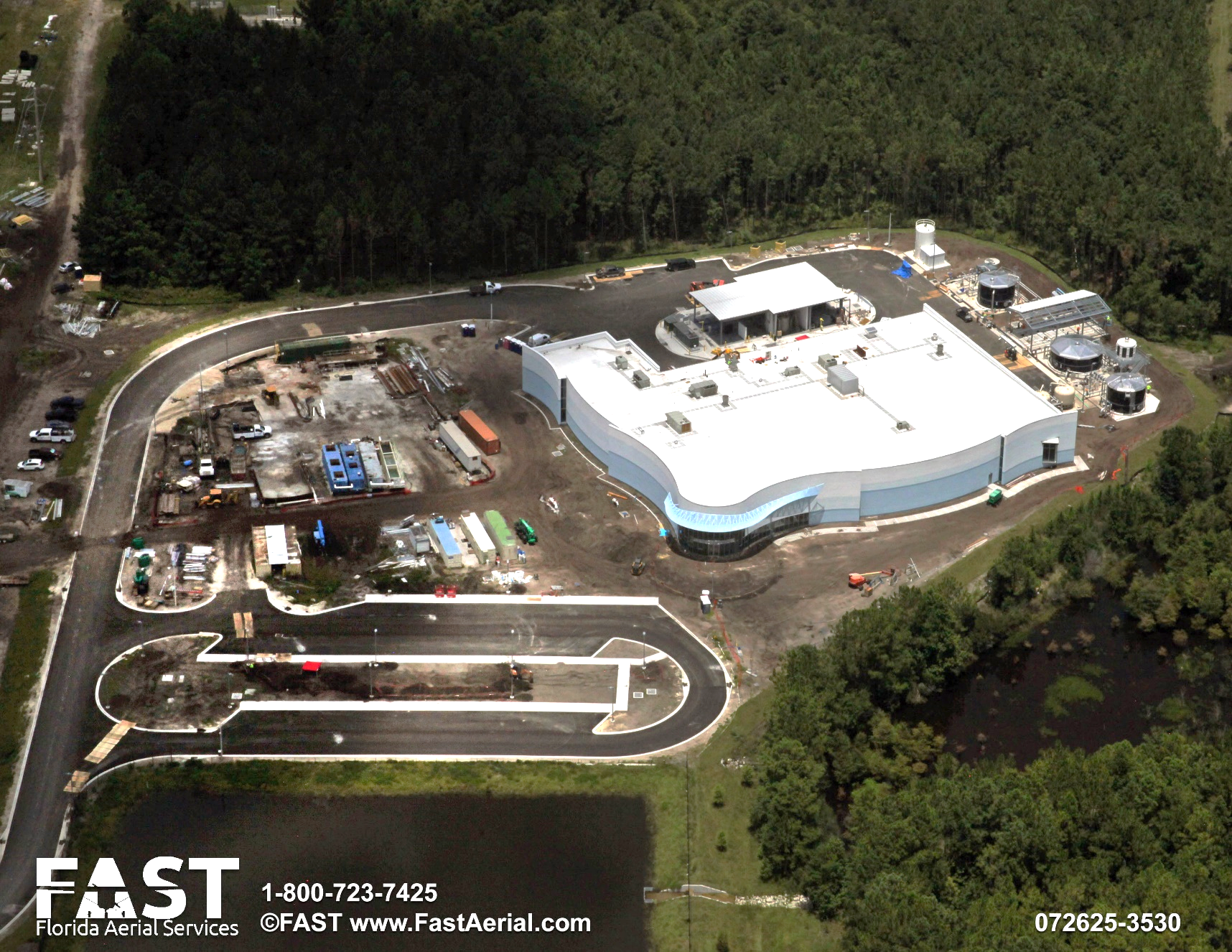

Bldg Enclosed, Awning Installed & Site Paved.
June 2025

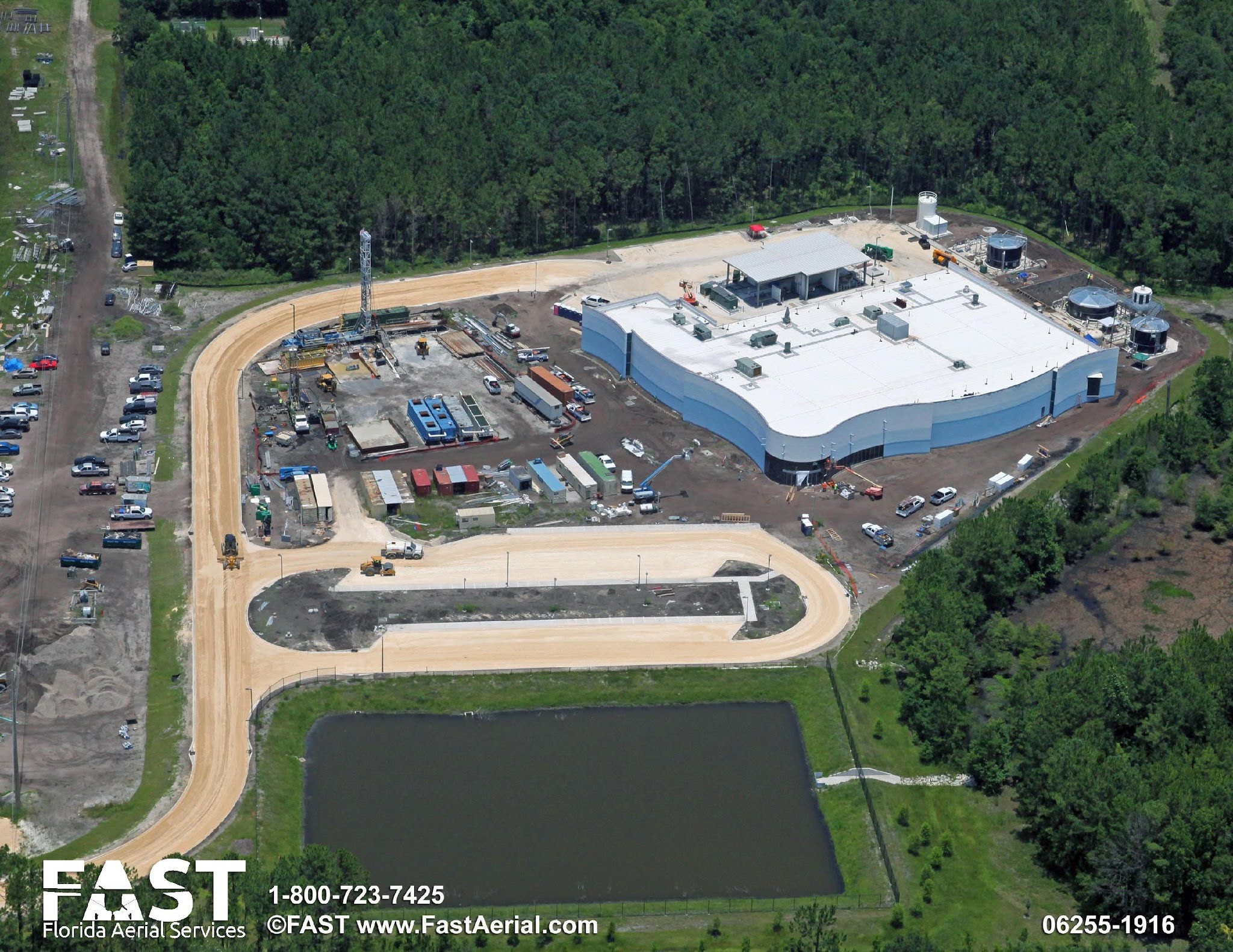

Lime system installed and road stabilized.
May 2025

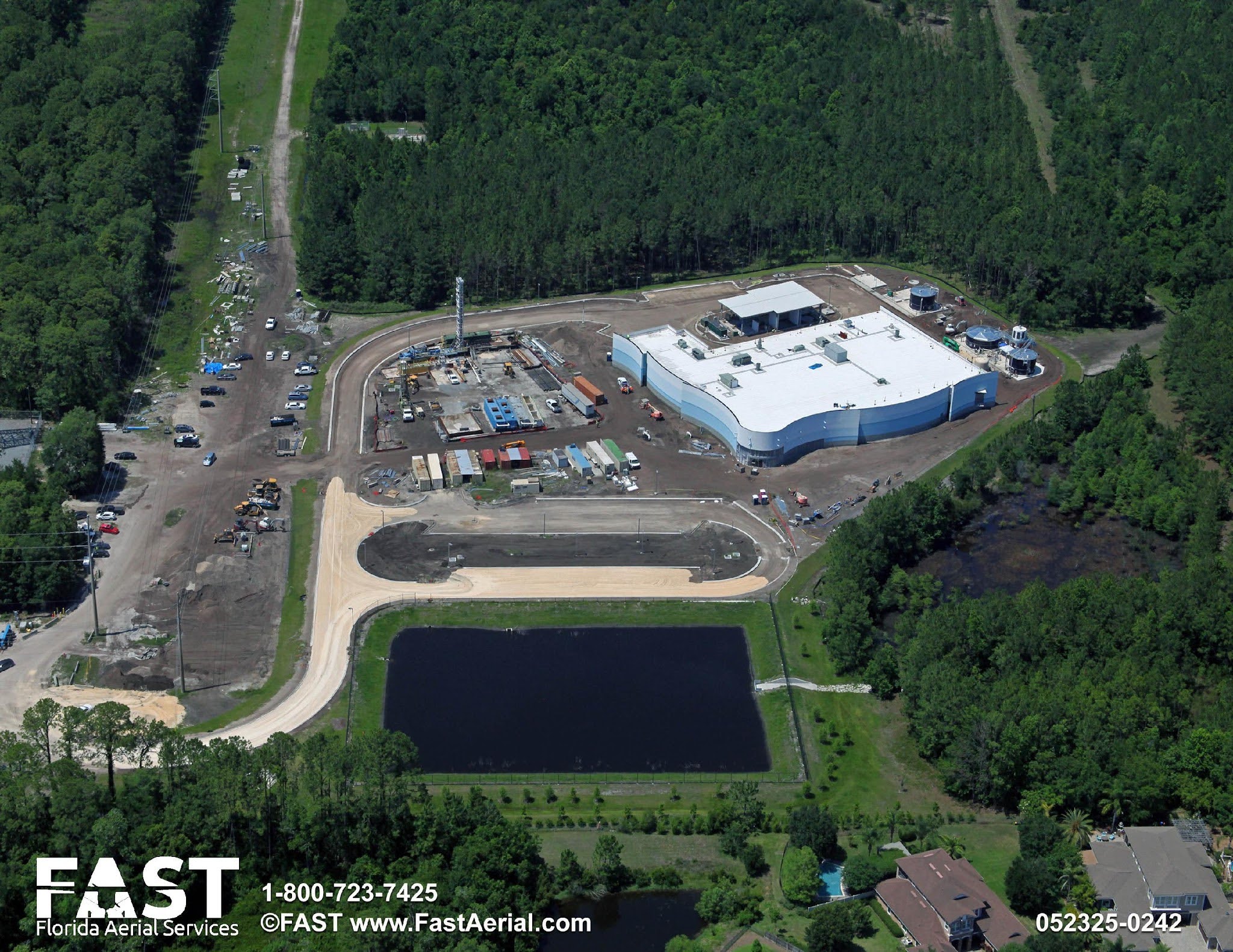

Exterior paint & replenishment well complete.
April 2025

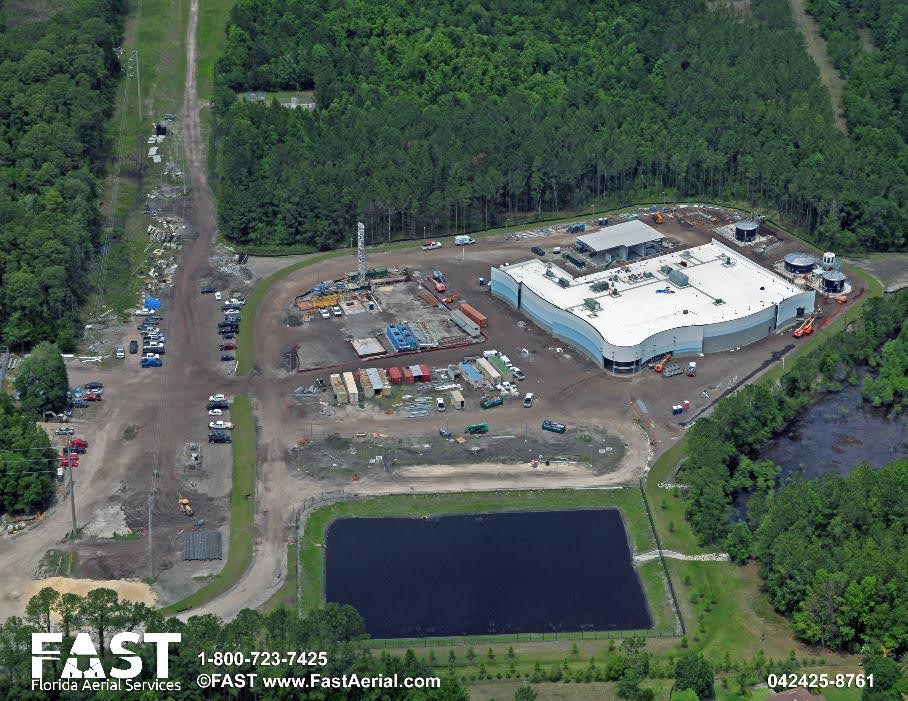

Begin exterior painting, HVAC installed.
March 2025

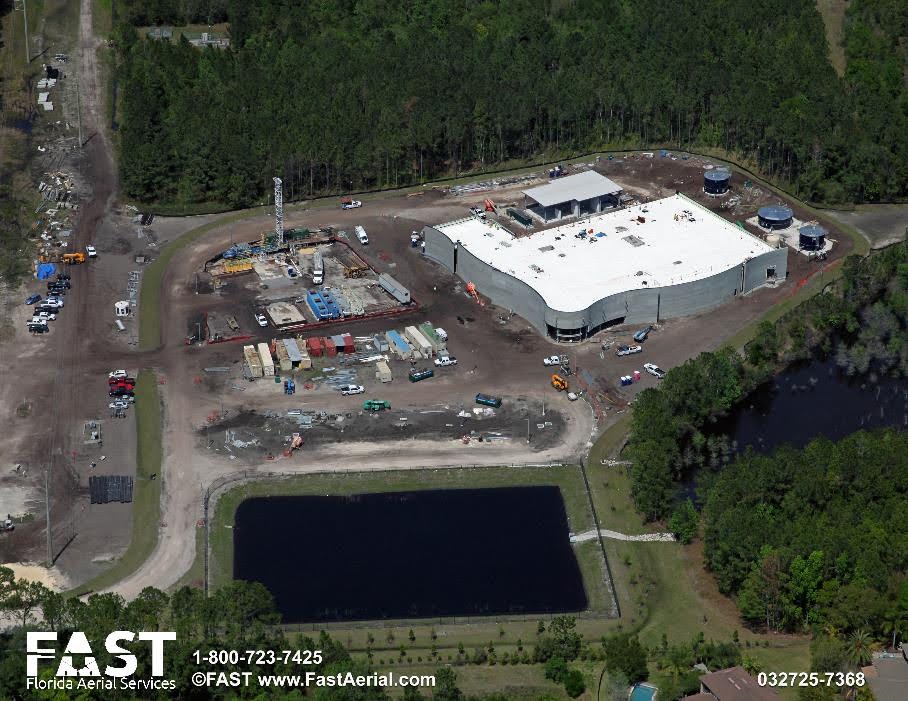

Carbon vessels installed and pads poured.
February 2025

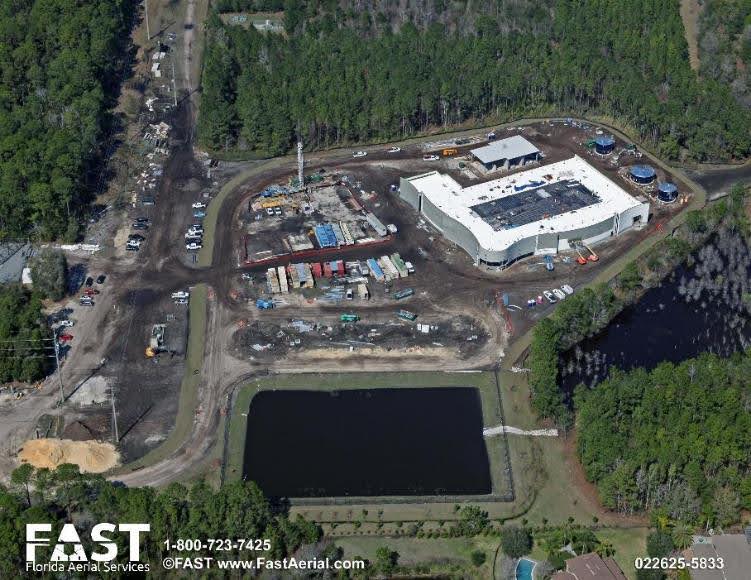

Continue coating building exterior and drilling well.
January 2025

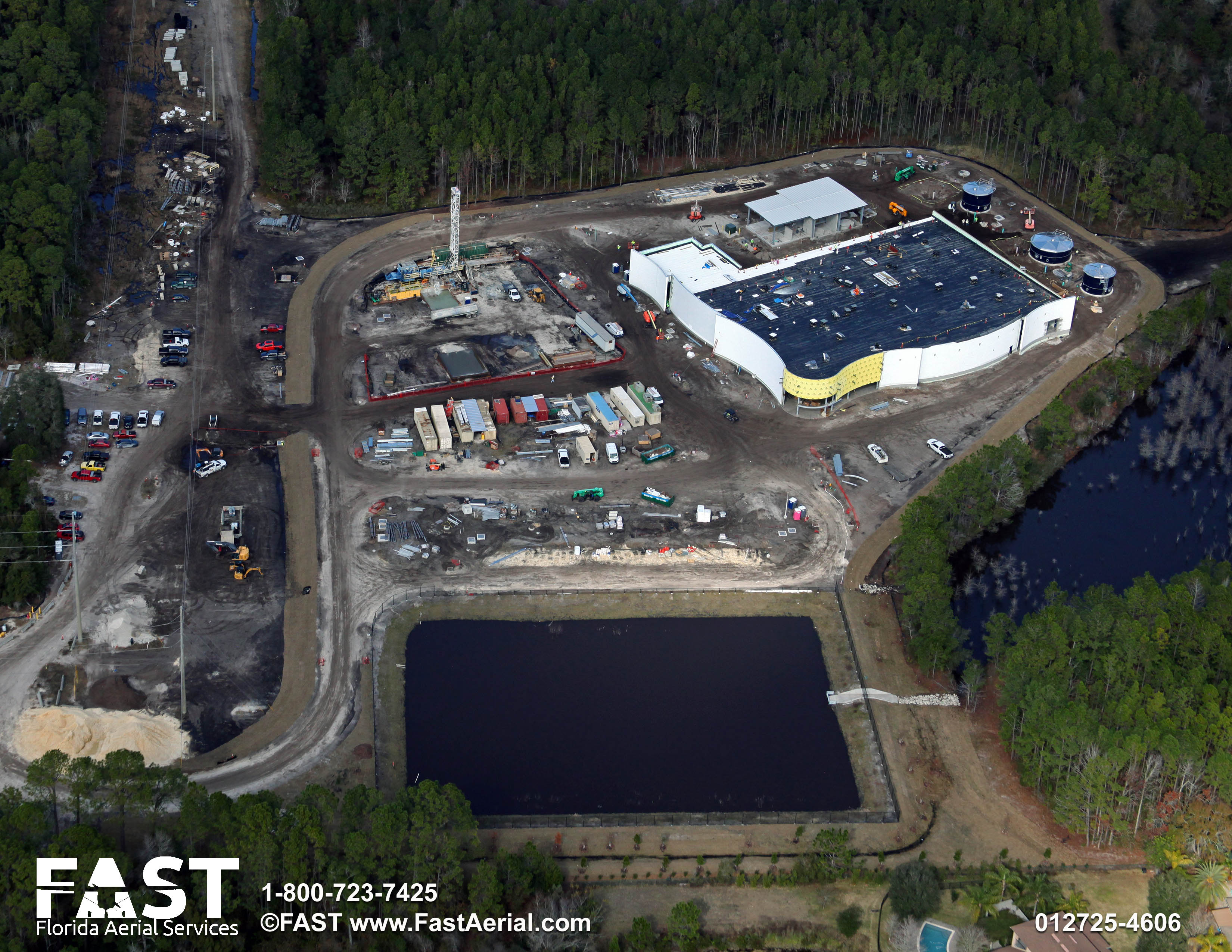

Chemical storage structure is installed behind the building.
December 2024

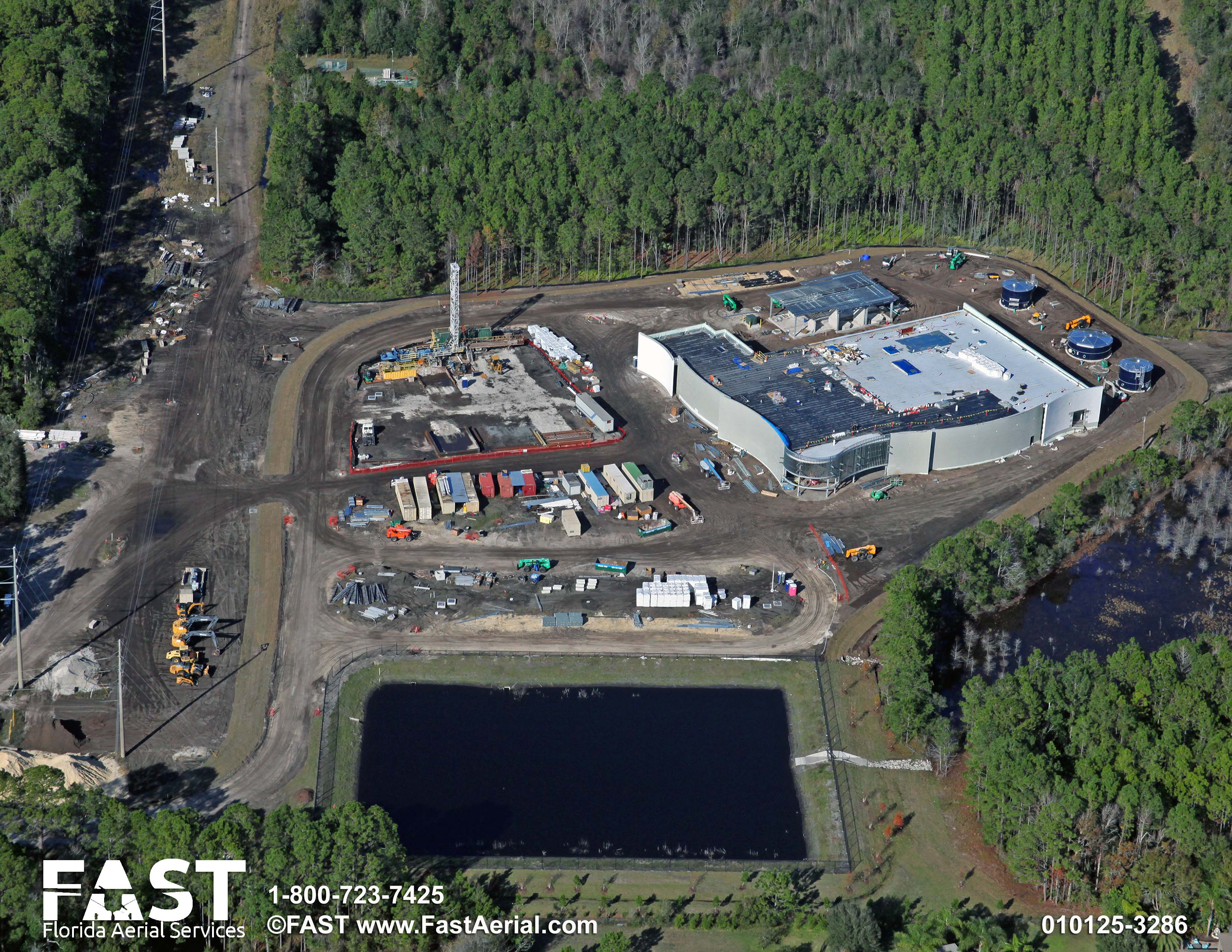

Building roof nearing completion and major equipment installed inside building.
November 2024

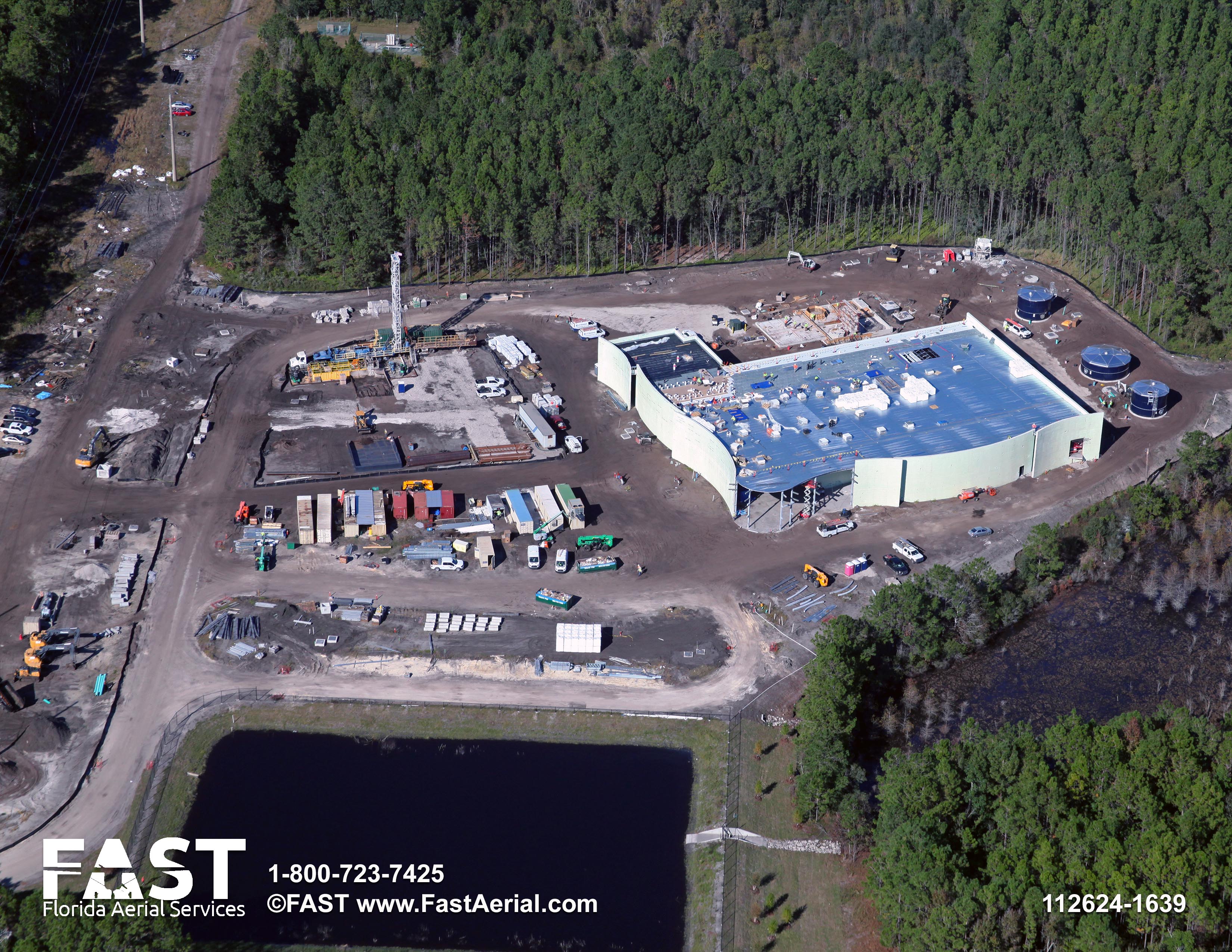

Water tanks in top left constructed and aquifer replenishment well construction begins.
October 2024

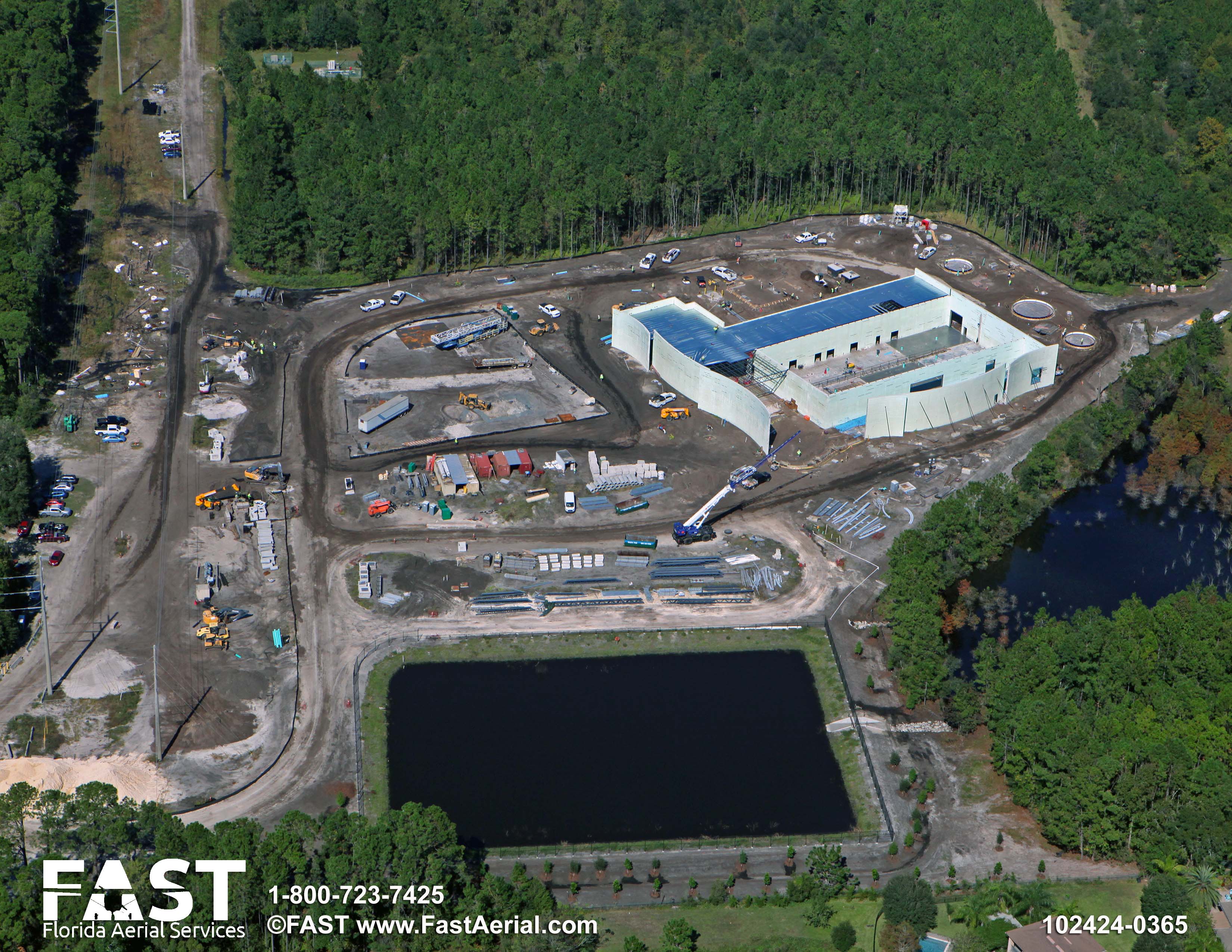

Building roof installation begins and well driller mobilizes on the top left corner of the site.
September 2024

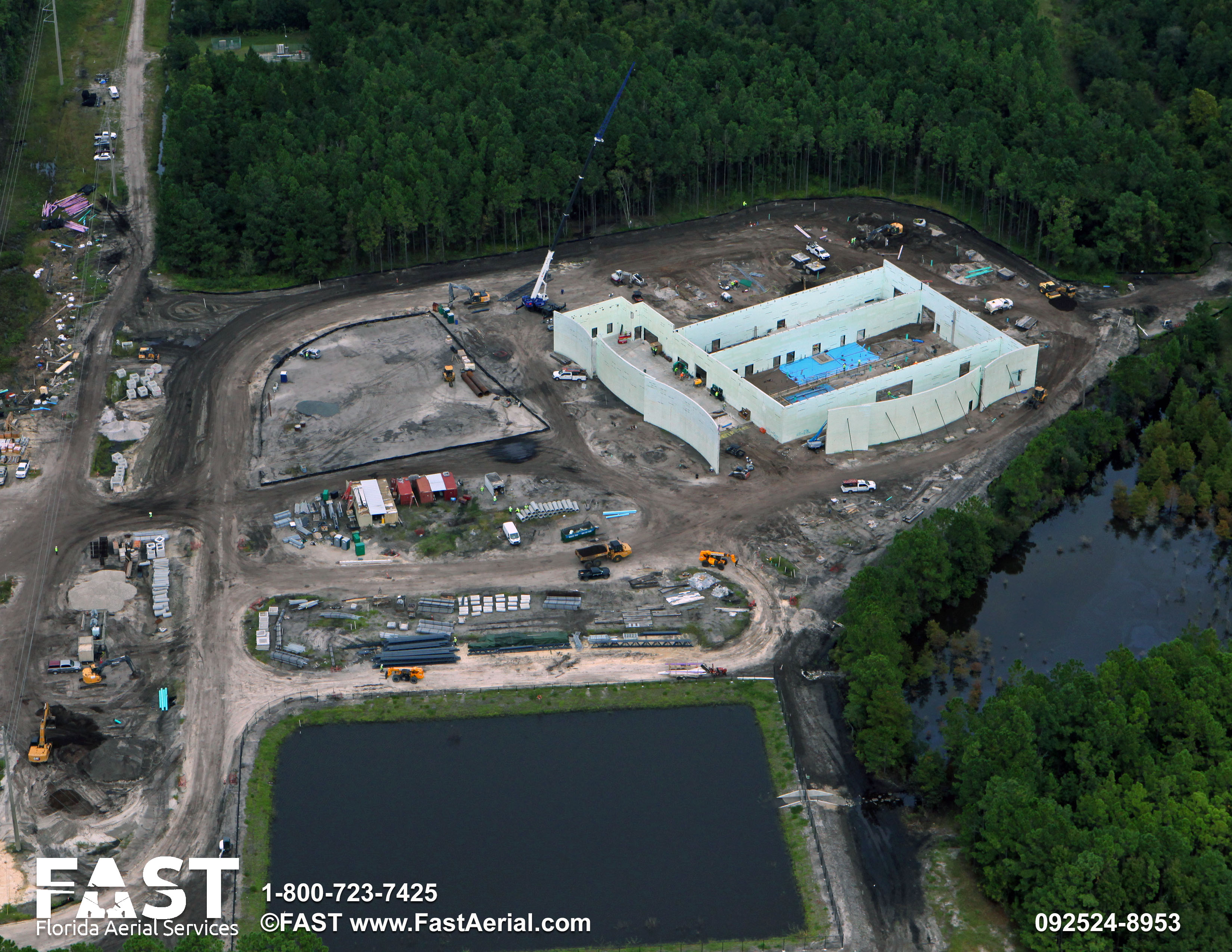

Construction of building walls and floors continue.
August 2024
As walls are set the building concrete floors begin being set.
July 2024

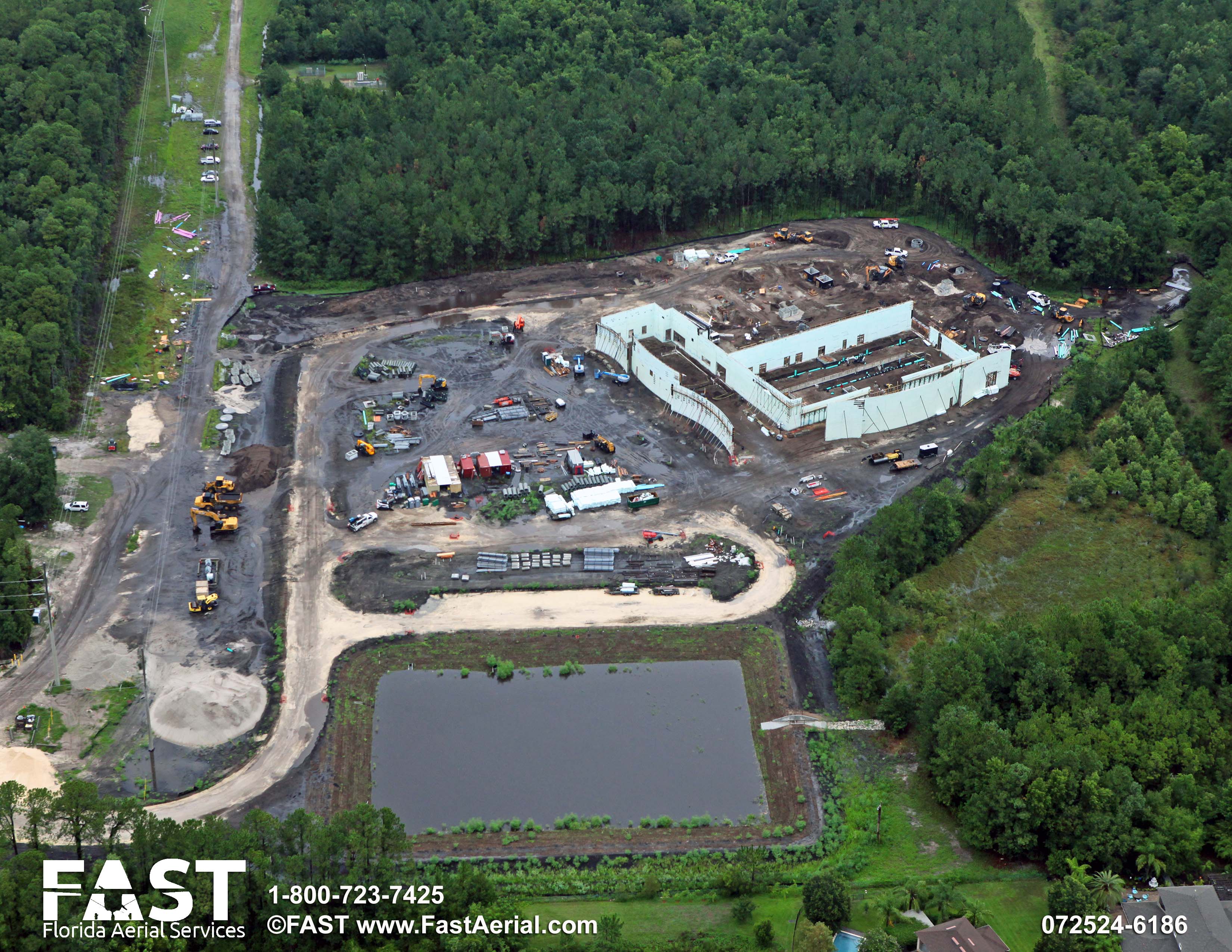

Exterior building walls are nearly complete.
June 2024

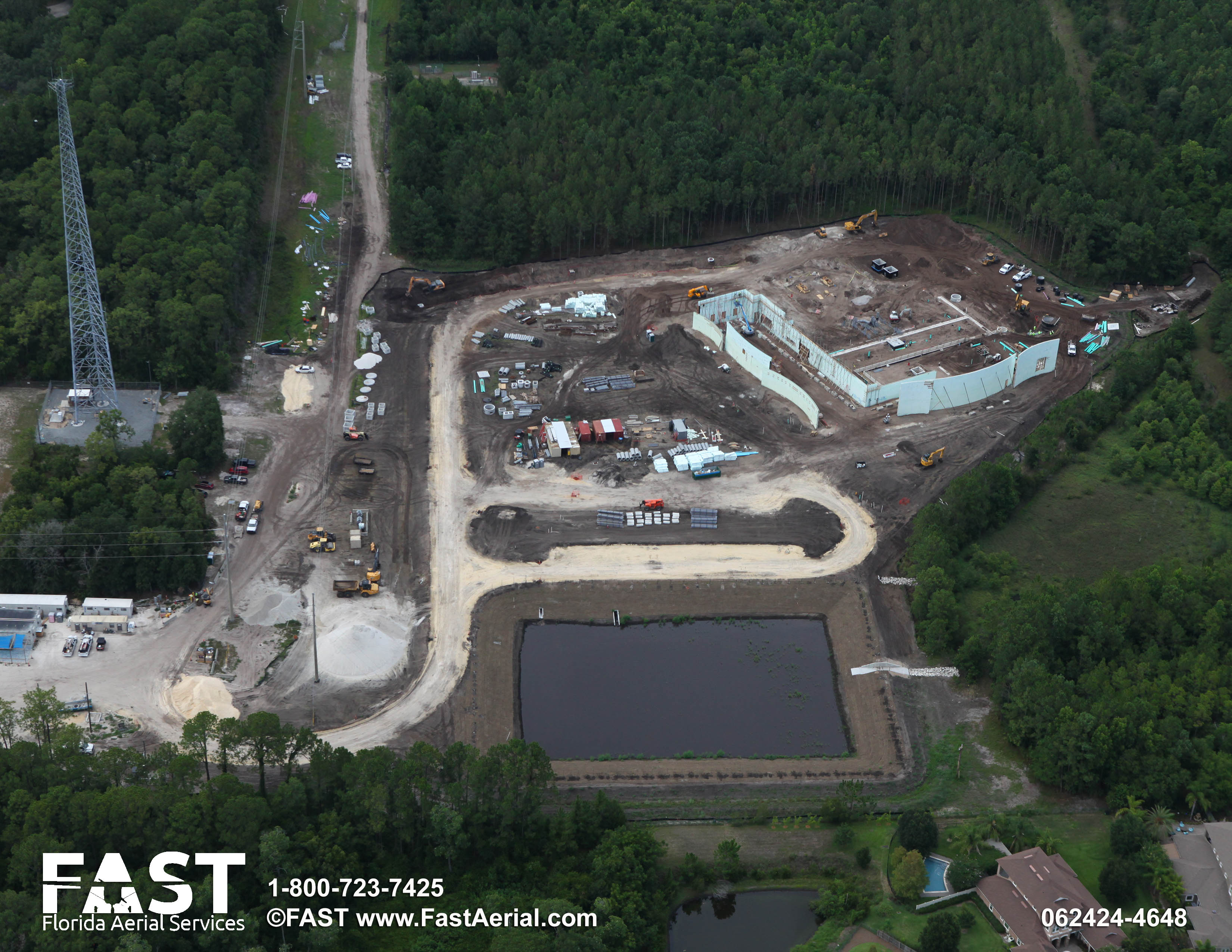

Building walls and structural foundation take shape.
May 2024

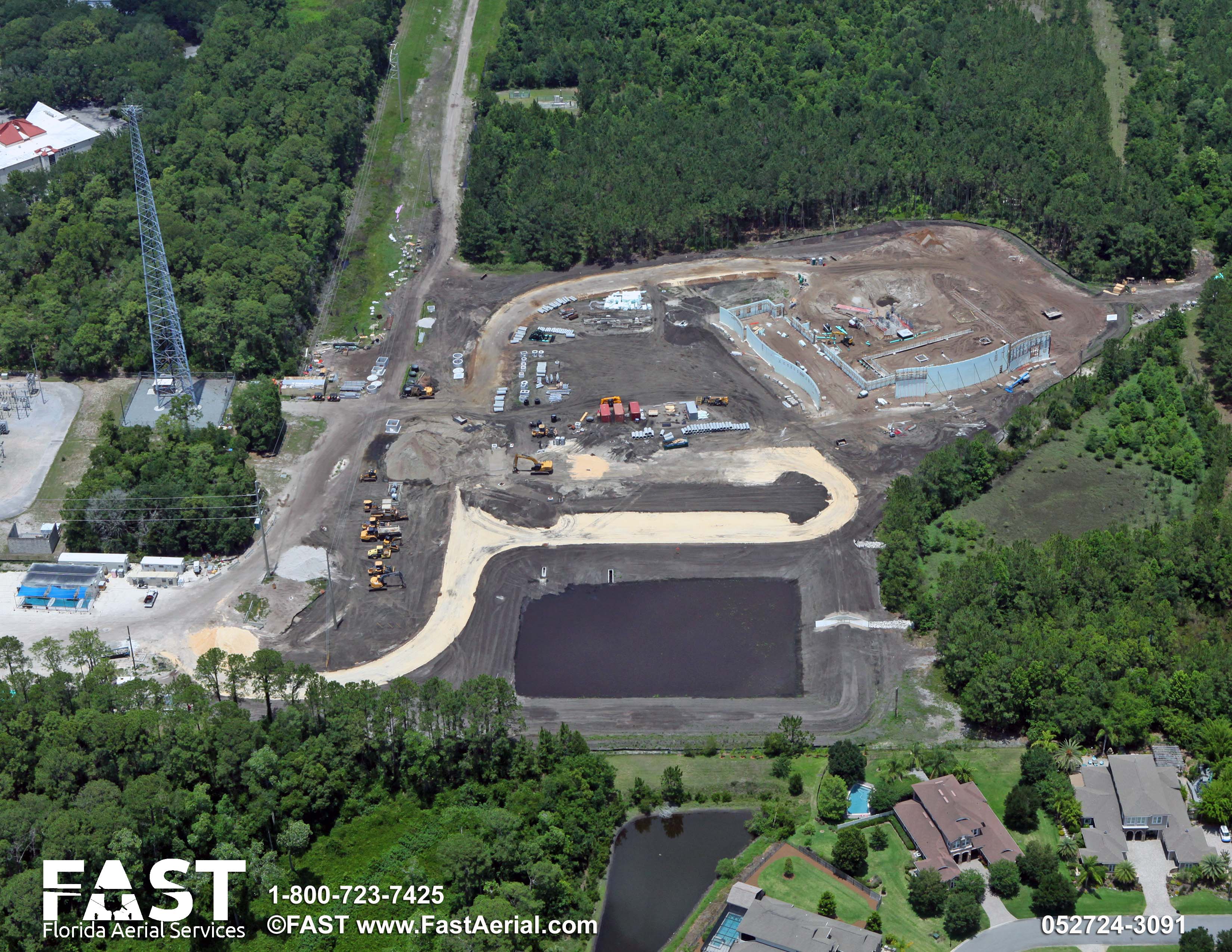

Visitor parking begins to take shape and stormwater pond is complete.
April 2024

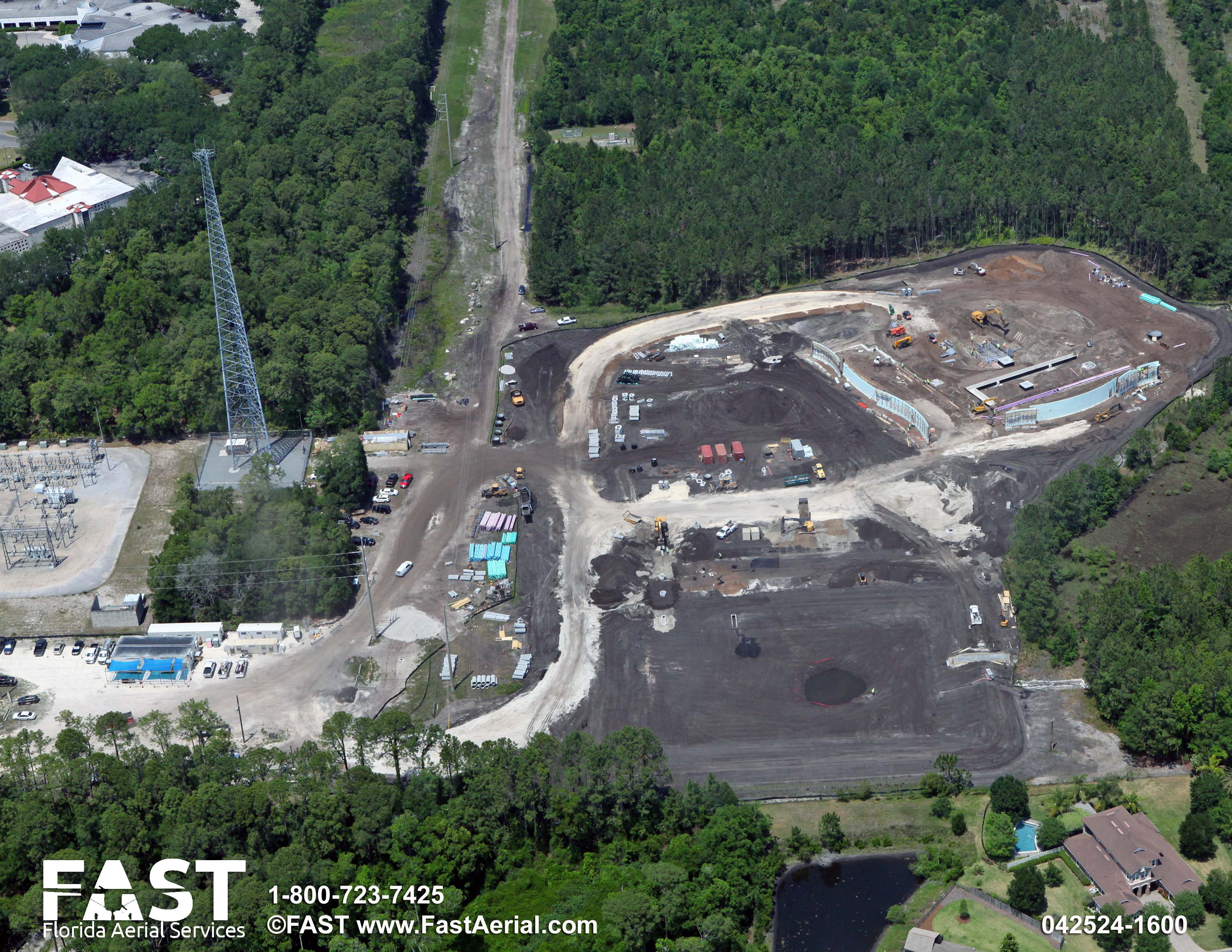

Chemical storage structure is installed behind the building.
March 2024
Building foundation starts in the top left corner of the site.
February 2024
Building foundation takes shape in the top left corner of the site.
January 2024

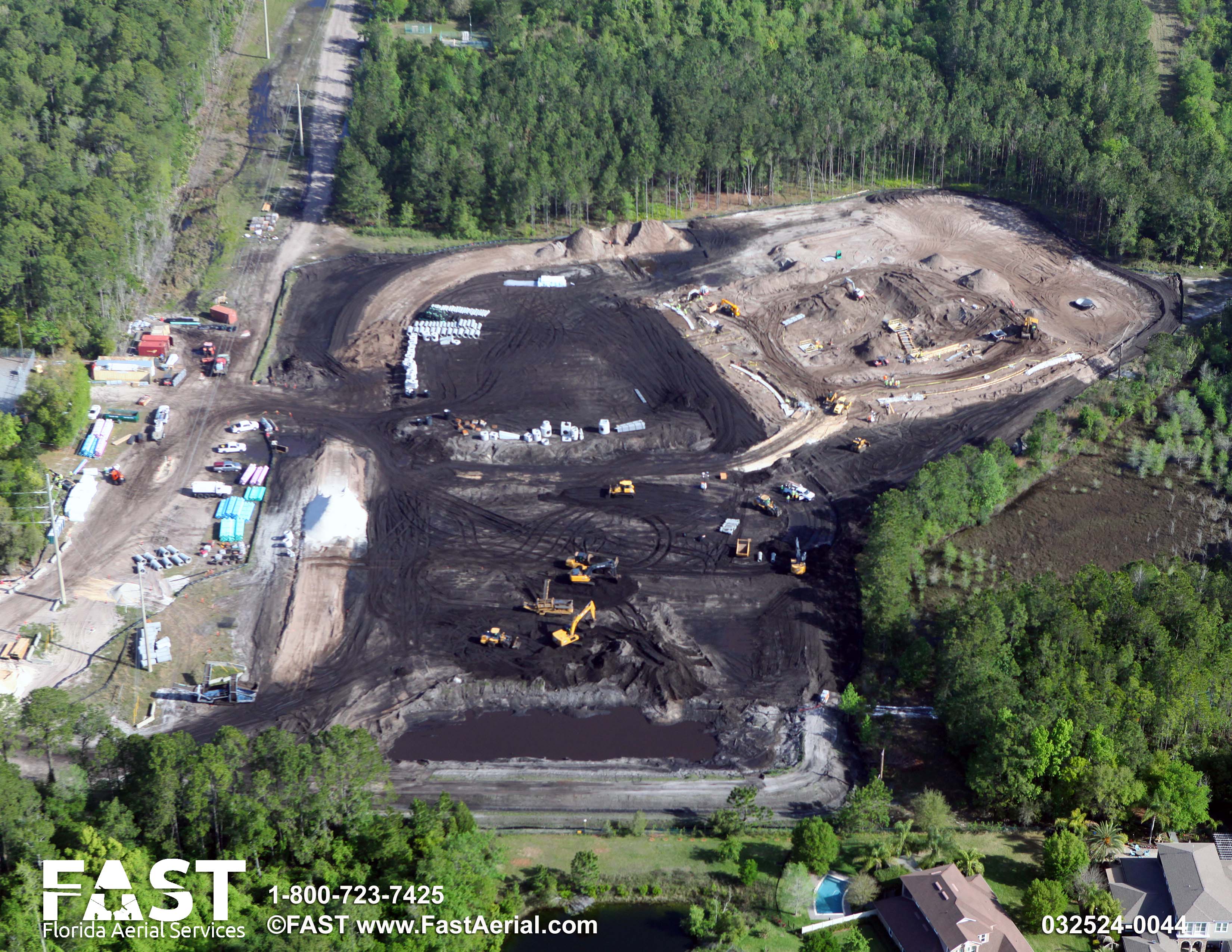

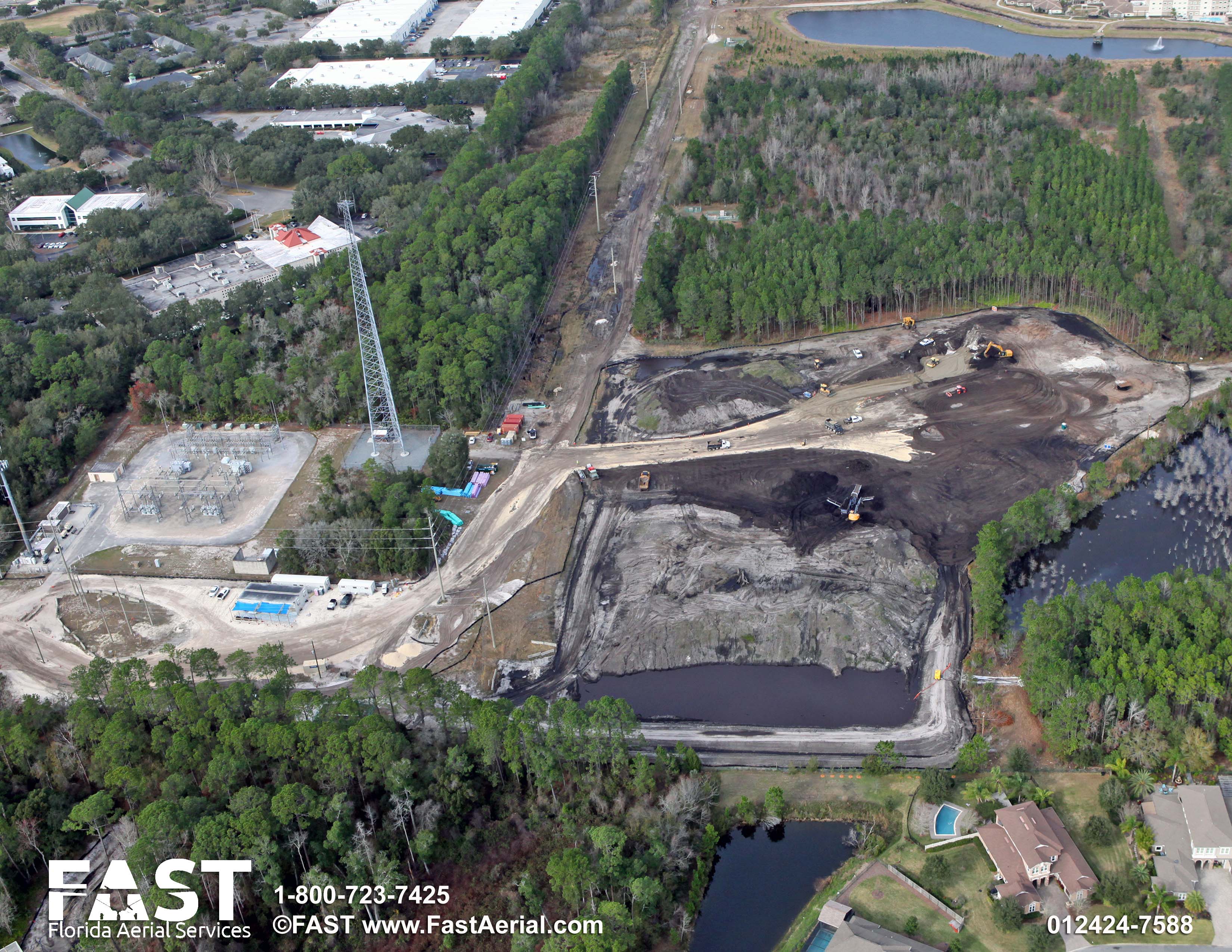

Construction begins with site clearing and the beginning formation of the stormwater pond.
